Leavenworth Substation Rebuild

Substation_program_planning to power_clr (002)
Bavarian webpage photo

Planning to Power - all the way to 2075

Substations are an integral part of Chelan PUD’s electrical power system, bringing together generation, transmission, and distribution. In alignment with the long-range vision of Imagine 2075, the Substation Program provides a strategic framework for proactively improving and expanding substation infrastructure. The PUD's Substation Program ensures we can continue delivering safe, reliable power to meet the evolving needs of Chelan County.

Stay Engaged!

Sign Up to be added to our email distribution list.

Questions or Comments?
 Please email [email protected] or
 call 509-661-8563.

Burdened Transformer

Background

When an existing substation is reaching 80% of its capacity, that is Chelan PUD's sign to begin looking into the need for a new substation. This '80/20 Model' launches the process for identifying a location for a new substation and the associated transmission and distribution lines that deliver reliable electricity to our customers.

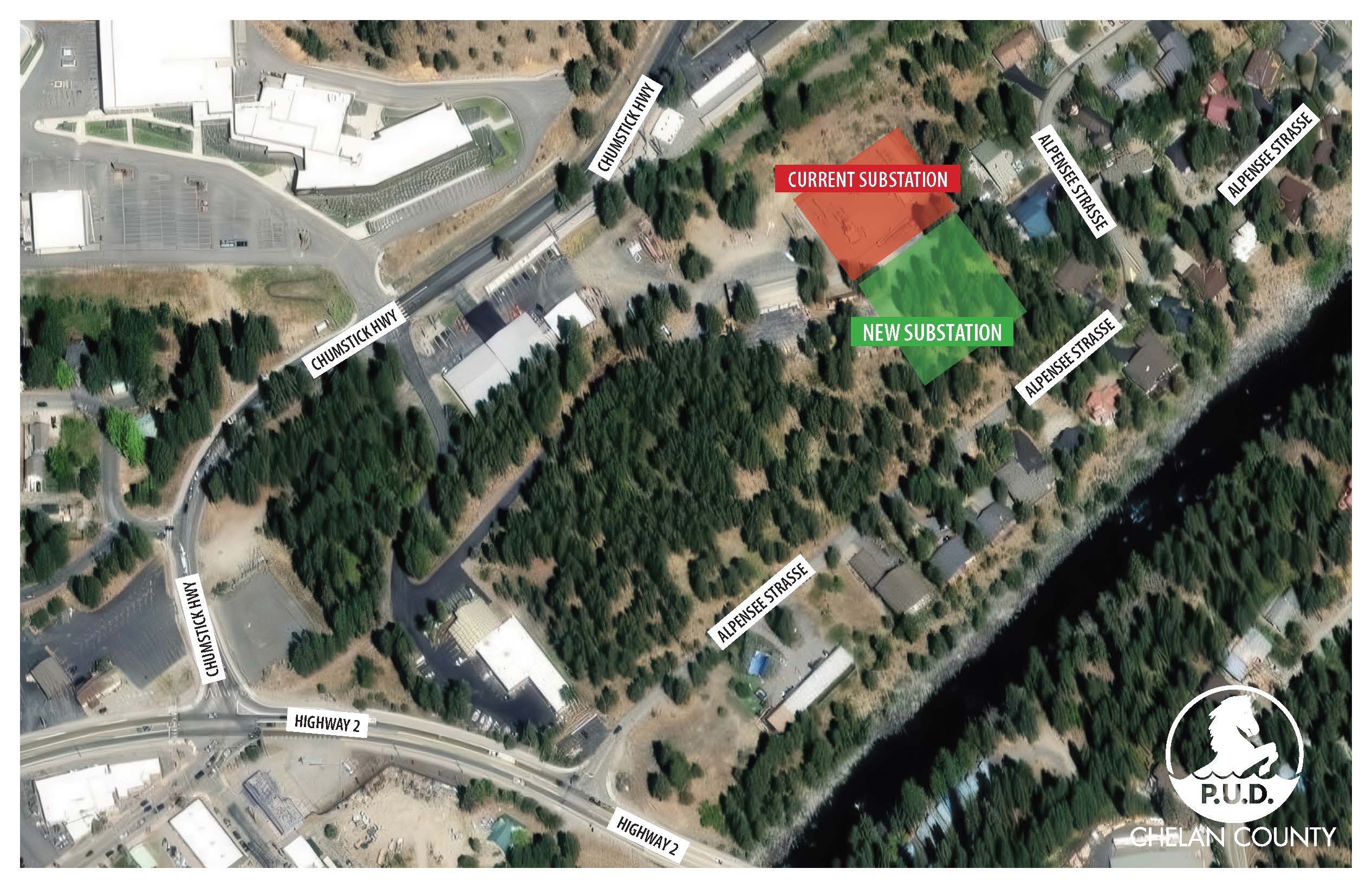

The existing Leavenworth Substation is nearing the end of its useful life and needs to be replaced. A new substation will be built adjacent to the existing Leavenworth Substation. The new substation will contain two new 28 MVA transformers, circuit switchers, a control house, and associated transmission and distribution lines.

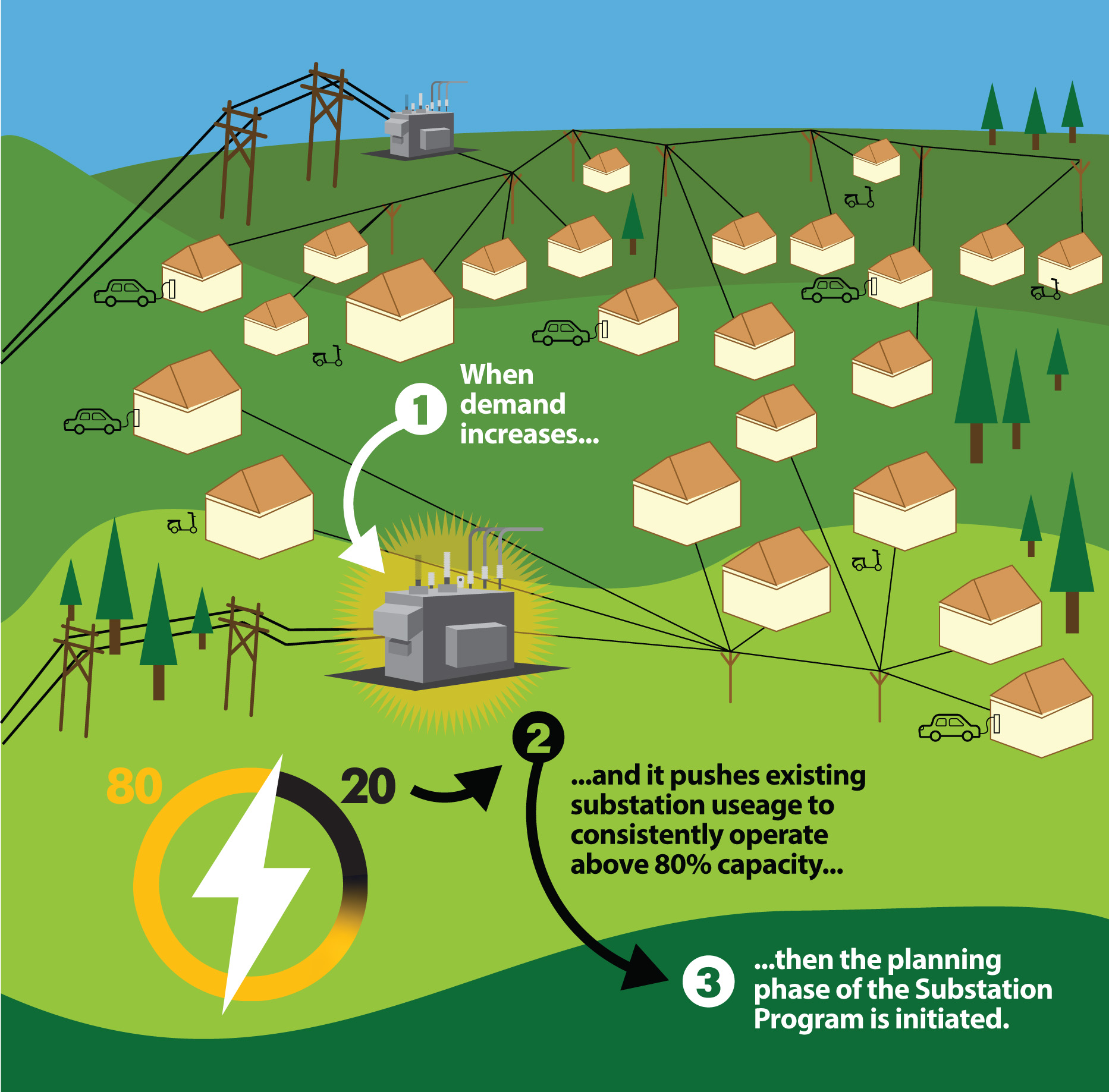

80-20 graphic

Upcoming Events


Nothing happening yet! Check back here for updates.


Recent Activities

October 10, 2025: Chelan PUD issues Determination of Non-significance

November 18, 2025: Leavenworth Community Engagement Night

December 18, 2025: Chelan PUD submits Conditional Use Permit application

February 3, 2025: Leavenworth Community Engagement Night

March 12, 2026: Q&A Drop-in at the Leavenworth Fire Station

April 7, 2026: Public Hearing on Chelan PUD's Conditional Use Permit

May 5, 2026: Leavenworth Community Engagement Night

September 25, 2026: Neighborhood Meeting - Layout and Aesthetics




3



         BUILD



2026-2027


  • Design of the substation and power lines
  • Pursue appropriate permitting
  • Construct the substation and power lines
  • New infrastructure serving customers

CONSULT:
We will listen to and acknowledge concerns during the design process.

INFORM:
We will keep the public informed during the construction process.
